What a Remodel Timeline Really Looks Like, Week by Week

A kitchen remodel spends more calendar on lead times and inspections than on labor. Cabinets and windows set the critical path before demolition starts.

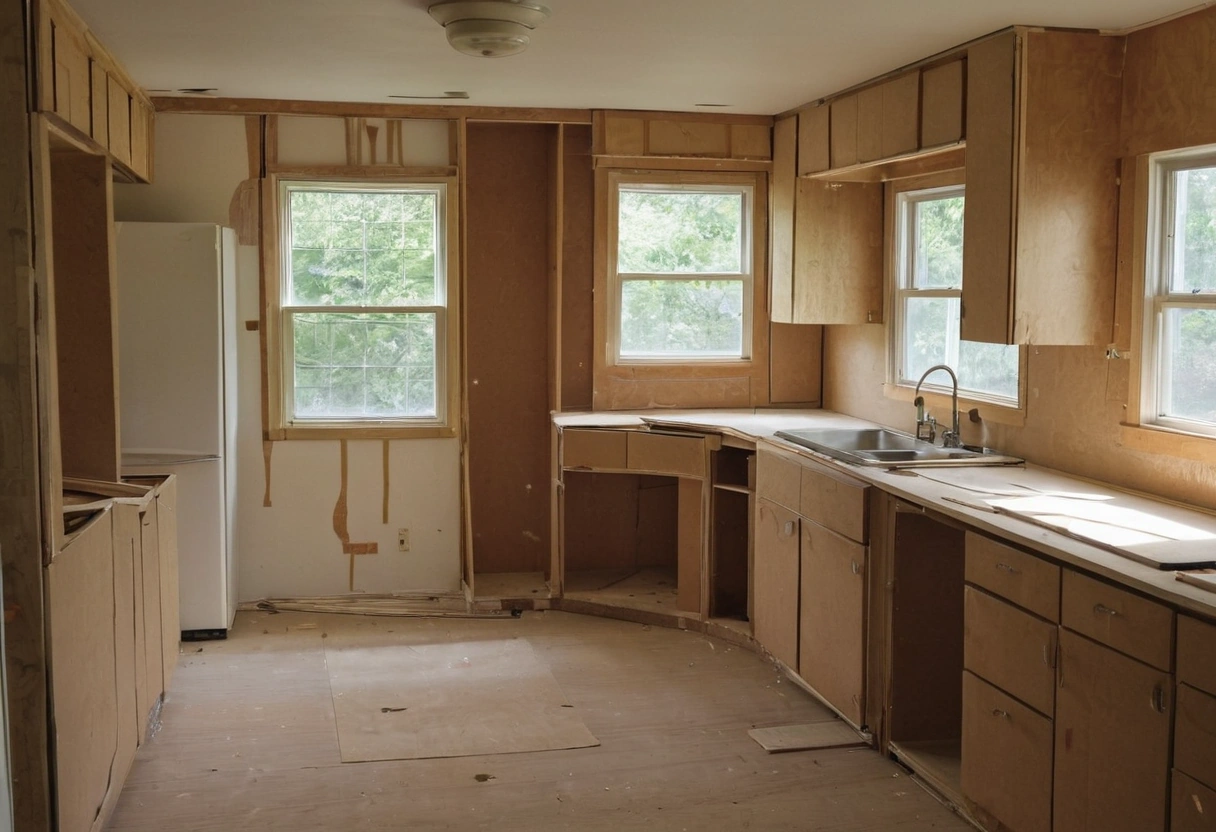

Kitchen stripped back mid-remodel with old cabinets in place and the floor pulled up
Kitchen stripped back mid-remodel with old cabinets in place and the floor pulled up.

A kitchen remodel spends more calendar on lead times and inspections than on labor. Cabinet manufacturing runs 6 to 12 weeks, countertop template and fabrication adds 2 to 3 weeks after cabinets are installed, and inspections gate the work in between. The demolition that homeowners picture as the start of the project is usually week 9 or later.

Understanding the sequence changes what a homeowner worries about. The crew size rarely determines the finish date. The order date does.

What does a realistic kitchen remodel timeline look like?

Typical sequence for a full kitchen remodel with permits
PhaseTypical durationWhat it gates
Design and selections3 to 8 weeksNothing can be ordered until this ends
Permit review2 to 8 weeksStructural or plumbing changes
Cabinet manufacturing6 to 12 weeksThe critical path for most kitchens
Demolition2 to 4 daysRough-in access
Rough electrical, plumbing, HVAC1 to 2 weeksRough-in inspection
Insulation and drywall1 to 2 weeksPaint and cabinets
Cabinet installation3 to 5 daysCountertop template
Countertop template and fabrication2 to 3 weeksBacksplash, sink, plumbing trim
Backsplash, trim, final finishes1 to 2 weeksFinal inspection
Punch list1 to 3 weeksCloseout

Add those together and a straightforward kitchen runs 4 to 6 months from first meeting to final walkthrough, with roughly 6 to 10 weeks of that as active work in the house.

The crew size rarely determines the finish date. The order date does.

What is the critical path in most kitchens?

Cabinets are the critical path for most kitchens, because nothing after them can start until they are installed and nothing before them matters if they are late. The second most common critical path is windows, when a remodel changes an opening, since window lead times behave like cabinet lead times.

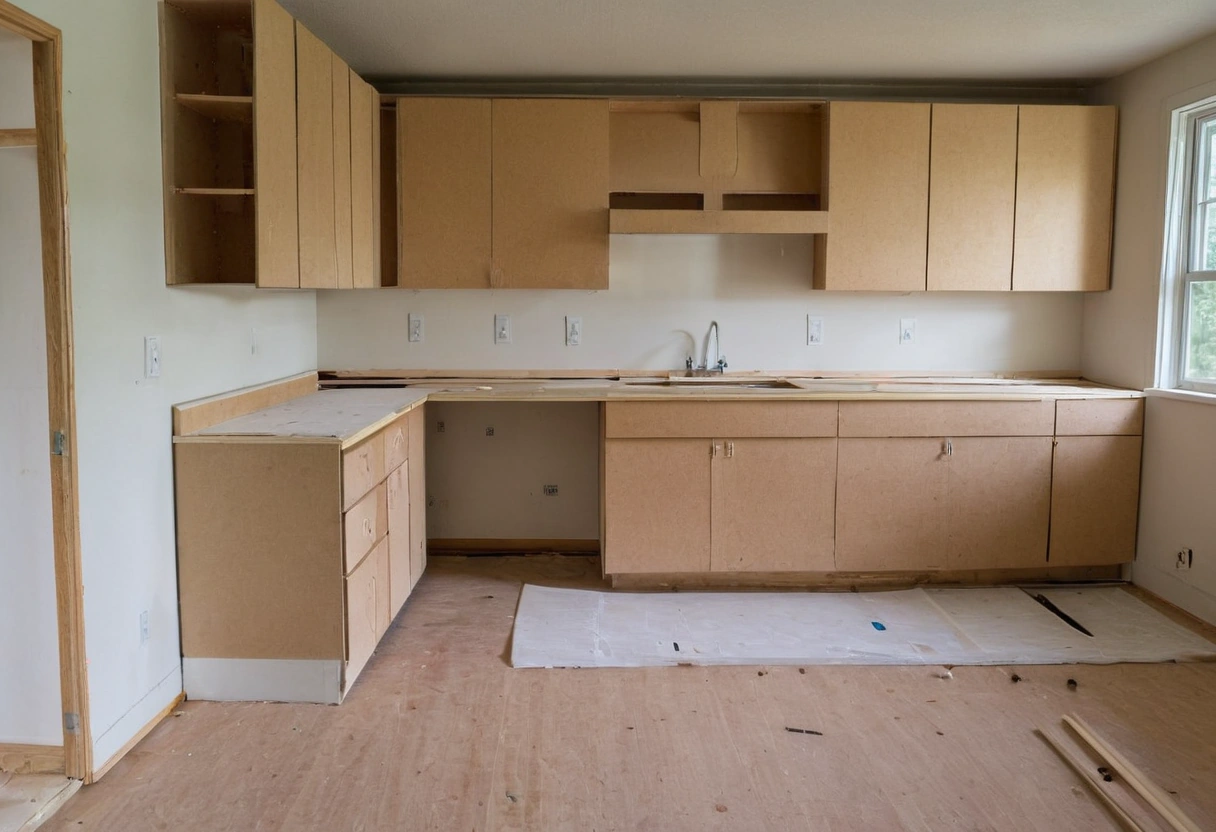

New cabinets installed with plywood strips where countertops will land
New cabinets installed with plywood strips where countertops will land.

The practical consequence is that selections should finish before demolition, not during it. A household that starts demolition while still choosing a cabinet door style will live without a kitchen for the length of the manufacturing lead time.

Why does the countertop take so long after cabinets?

Countertops get templated on the installed cabinets, because a template made from drawings does not match a real room. After template, fabrication takes 7 to 14 business days depending on the shop and the material. During that window, the kitchen has cabinets and no working sink.

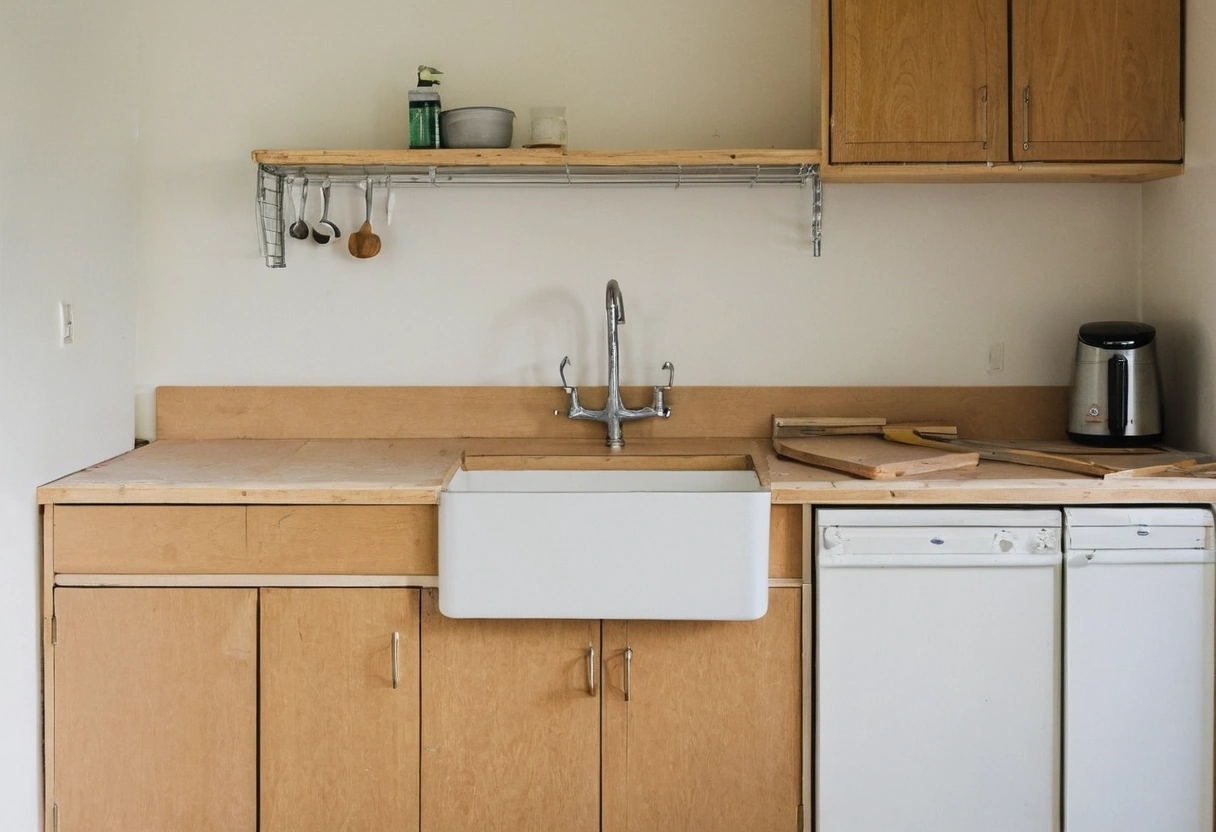

Unfinished kitchen with the sink connected and open shelving not yet loaded
Unfinished kitchen with the sink connected and open shelving not yet loaded.

Some contractors bridge that window with a temporary plywood top and a utility sink hookup. It is worth asking whether that is included, since two to three weeks without a kitchen sink is the part of a remodel households remember.

What extends a remodel beyond the estimate?

  • Change orders after rough-in. Moving an outlet after drywall costs a fraction of the work but resets the inspection.
  • Hidden conditions. Knob-and-tube wiring, rotted subfloor and undersized headers surface at demolition.
  • Backordered appliances. A missing appliance blocks final inspection when a hood or a range is part of the permitted scope.
  • Inspection scheduling. Jurisdictions with 5 to 10 business day inspection queues add weeks that no crew can compress.
  • Selections made late. Tile, plumbing trim and hardware all have their own lead times.

How to compress a remodel honestly

  1. Finish every selection before ordering cabinets, including hardware and plumbing trim.
  2. Order long-lead items first, even before the permit clears, when the design is settled.
  3. Ask the contractor to book inspections the moment a phase is scheduled rather than when it finishes.
  4. Keep a written decision log so that a question answered in March does not get reopened in May.
  5. Accept the plywood countertop bridge if it is offered, since it restores the sink two weeks early.

None of those steps adds labor. All of them remove waiting, which is where a remodel schedule actually goes.
